Workload hours allocation

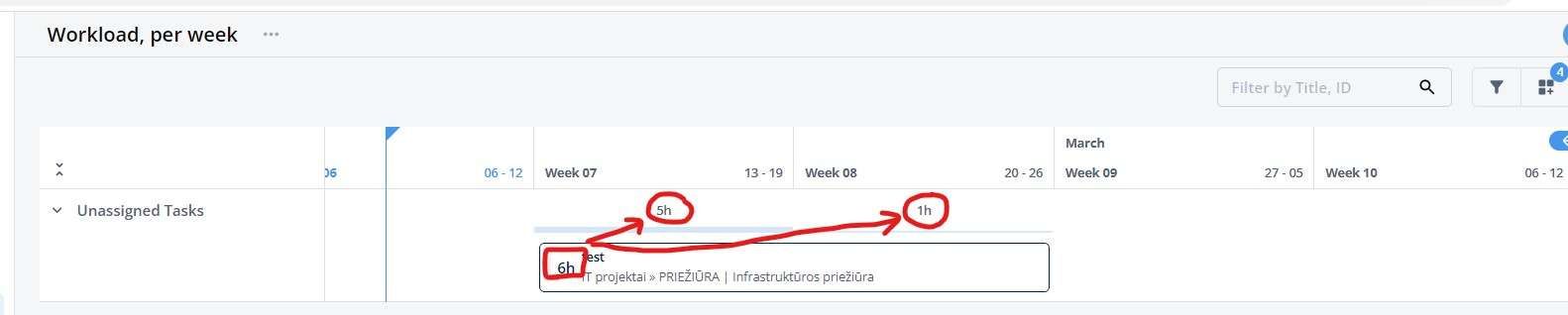

The current allocation of workload hours is based on a method that allocates hours disproportionately (e.g. 6 --> 5 + 1). See attached picture. It would be very helpful if hours are allocated proportionately (i.e. 6 --> 3 + 3, not 6 --> 5 + 1). Alternatively, the user should be able to change the method themselves.

Log in to comment and vote
Comments9
May 10, 2023
Diego Villalobos
May 11, 2023
Vidas: Thanks a lot!
Please fix these two issues:
https://teamhood.canny.io/feature-requests/p/suspended-items-workload
https://teamhood.canny.io/feature-requests/p/workload-error-for-multi-assigned-tasks
Apr 24, 2023
Feb 14, 2023
Vilius Pukėnas
Feb 10, 2023
I agree that current logic of allocation time for days is reasonable. Just it might be quite confusing if you plan a time for weeks or months, not days. The possible solution might be extra radio buttons in scale settings (see picture attached) if it is not to complicated to a user.
Vidas
Feb 10, 2023
Vilius Pukėnas: given this is a small part of workload feature, we try to minimize configuration options because that makes tool more complex, so we will decide whether we can just simply do adaptive hour splitting based on scale mode. Days will use old way, weeks/months/quarters will divide hours equally without taking days into account.
Feb 10, 2023
Vidas
Feb 10, 2023
Vilius Pukėnas this is definitely an issue with equal division logic. Teamhood allocates time for days behind the scenes, so if you schedule something for 10 business days and only 6 hours -> first 6 days get 1 hour each, hence the weekly sum is 5 and 1. I will log this as an issue in our backlog and we will figure out a better way. Sorry for the inconvenience.
Olivér Varga
Nov 15, 2022
So currently if I have a 15 m task (shortest time) then it can show a 15m workload, but if I have a 1 h task spread across 4 days, it loads 1h on the first day and 0h on the other 4.
What I would like is to spread 15m on each of the 4 days.
